How to Build a 24 Hour Coverage Shift Schedule That Actually Works

Robert Cain
Employee Relations Specialist
24 Hour Coverage Shift Schedule

Work-related fatigue costs U.S. employers $218 billion or more a year in reduced productivity and absences, according to a 2023 NIOSH science bulletin. A 24 hour coverage shift schedule fixes crew count, weekend rhythm, and structural overtime at once, and overtime surfaces only after the first payroll run. Compare the standard patterns first, then check headcount against the books. This guide covers both, then how to fix it when a live schedule slips.

TL;DR

  • Five patterns cover most continuous operations: the 8-hour three-shift, 12-hour 2-2-3, DuPont, Pitman, and 4-on-4-off.
  • Crew count, rotation length, weekend impact, and overtime exposure are the four variables that set them apart.
  • One continuously staffed post needs roughly five employees once you factor in absences, above the 4.2 the raw math suggests.
  • Shift length, rotation style, and team count are three separate decisions, and you can change each without redoing the others.
  • Structural overtime is an output of the pattern, so it belongs in the budget before the schedule goes live.
  • SMS-based platforms like Yourco keep every crew reachable when the schedule moves.

Quick-Start: Proven 24 Hour Coverage Shift Patterns at a Glance

Five patterns cover most 24 hour coverage shift schedule needs: the 8-hour three-shift, the 12-hour 2-2-3, DuPont, Pitman, and 4-on-4-off. Each trade crew counts, rotation length, weekend impact, and overtime exposure differently, and the table below lays out those trade-offs side by side so operations and plant managers can compare them in one place. Rotation length means the full repeating cycle, or the number of days before the sequence restarts identically for every crew.

Pattern
Crew count
Rotation length
Weekend impact
Overtime exposure
8-hour three-shift
3 crews for 24/5; 4 crews for true 24/7 (Continental variant)
28 days (Continental)
The 3-crew version leaves weekends uncovered; Continental gives about one full weekend off per month
About 2 hours per week above 40 on average, at 42 scheduled hours
12-hour 2-2-3 (Panama, rotating)
4
14-day work sequence; 28 days for the full day and night rotation
Every other weekend off as a 3-day weekend
8 overtime hours every other week, as 48-hour weeks alternate with 36-hour weeks
DuPont
4
28 days
Rotates through the cycle with no fixed weekend-off guarantee
Uneven: 8, 32, 8 and 0 overtime hours across the four weeks, 48 hours per cycle
Pitman (fixed 2-2-3)
4 (two permanent day crews, two permanent night crews)
14 days
Every other weekend off as a 3-day weekend
8 overtime hours every other week
4-on-4-off (12-hour)
4 crews for day and night coverage
8 days
Rolling, with roughly half of all weekends worked
Varies as the 8-day loop drifts against the calendar; any workweek containing four shifts carries 8 overtime hours

Three of those names describe the same underlying sequence, which causes most of the confusion in vendor documentation. 2-2-3, Panama, and Pitman all run 2 on, 2 off, 3 on, 2 off, 2 on, 3 off. The difference is day-and-night assignment: Pitman crews stay permanently on days or nights, while the rotating Panama version moves crews between days and nights across a 28-day cycle. Policing and emergency services tend to say Pitman, and manufacturing tends to say Panama.

The overtime column is where the patterns separate in ways that show up in the budget. Every 12-hour pattern above averages 42 scheduled hours per week, but the distribution differs: Pitman and rotating 2-2-3 deliver a predictable 8 overtime hours every other week, 4-on-4-off produces them whenever a calendar week holds four shifts, and DuPont concentrates hours into a single 72-hour week, then repays them with seven consecutive days off later in the same 28-day cycle.

Weekend impact is the second lever, and it is usually the one the workforce cares about most, because a guaranteed 3-day weekend every other week retains staff in ways a rolling half-worked weekend calendar does not.

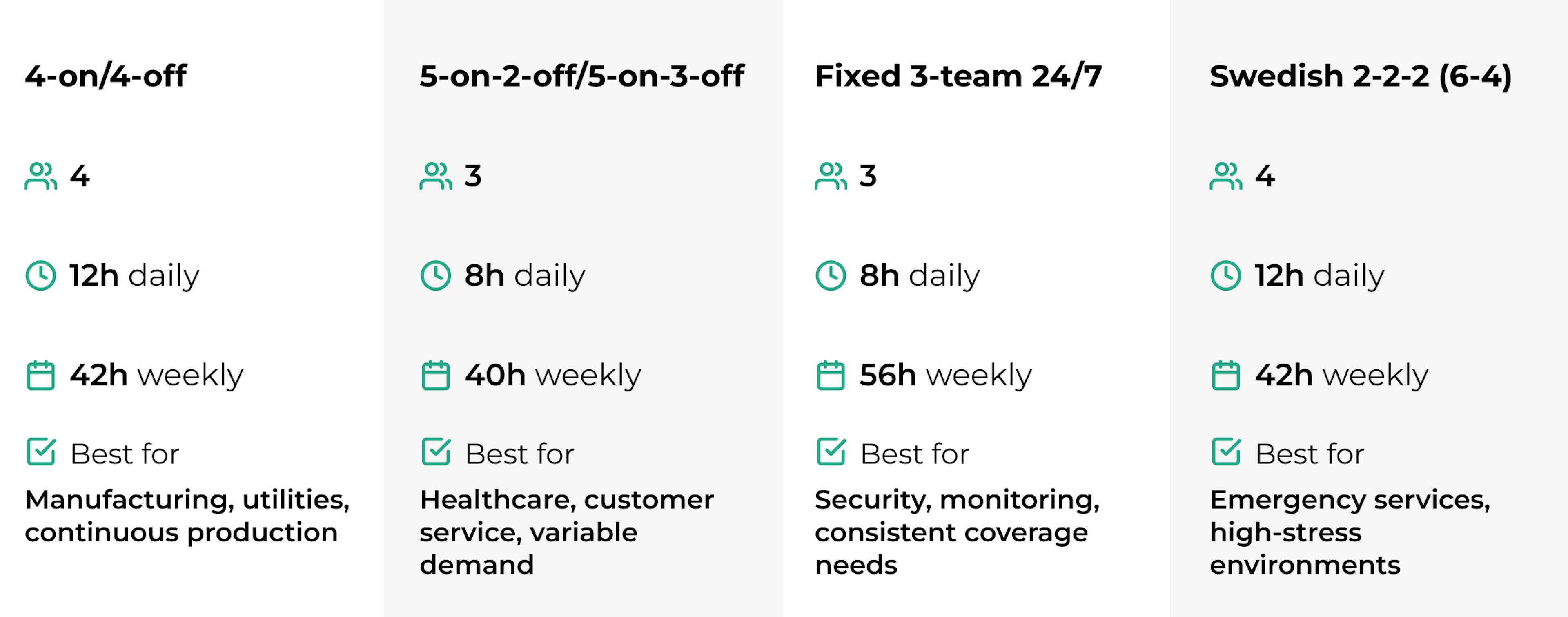

Beyond the five headline patterns, four variations come up often enough in continuous operations to be worth naming.

4-on/4-off, 12-Hour (4 Teams)

Employees work four consecutive 12-hour shifts followed by four consecutive days off. The alternating cycle is predictable, provides long recovery blocks between work periods, and gives employees extended weekends on a rolling basis. Manufacturing operations favor it because long shifts are already the norm there, and the extended time off helps retain people.

5-on-2-off / 5-on-3-off, 8-Hour (3 Teams)

A three-team structure where employees work five 8-hour shifts, take two days off, then work five more shifts and take three days off. The pattern maintains continuous weekday coverage without heavy overtime, which suits healthcare and other settings where 8-hour shifts are standard. The two-day break allows for normal recovery, and the three-day break provides a longer reset.

Fixed 3-Team 24/7, 8-Hour

Three fixed teams work morning, afternoon, or night shifts of 8 hours each. Predictability is the main advantage, because employees can plan around consistent hours and managers can staff to a known pattern. One caution matters here: three crews on 8-hour shifts can only sustain true seven-day coverage with heavy weekly hours or dedicated relief staff, so operations that need weekends covered on 8-hour shifts typically add a fourth crew and run a Continental-style 28-day rotation instead.

Swedish 2-2-2 (6-4)

Employees work two days on, two days off, two days on, then take four days off. The four consecutive days off every other week give a genuine reset, which is why the pattern appears in high-intensity environments where recovery time is the constraint rather than headcount.

Manufacturing, healthcare, security, and energy operations have run these 24 hour coverage shift schedules for decades. A broader guide to shift types covers structures that fall outside continuous coverage. The sections that follow explain how to choose between these patterns and adapt them when none fits cleanly.

How to Build Your 24 Hour Coverage Shift Schedule in 5 Steps

A 24 hour coverage shift schedule comes together in five steps: map demand and critical roles, select shift length, pick a rotation style and team count, run the cost and compliance numbers, and validate the draft with employees before the rollout.

Working through the five steps in order prevents the two most expensive mistakes: choosing a pattern before you know the demand curve and finalizing a schedule before the people working it have seen it.

Step 1: Map Demand and Critical Roles

Start by analyzing operational demand hour by hour, day by day. Identify peak periods, then set the minimum staffing each role needs during each window, separating positions that require coverage at all times from those that can run lean during quiet hours.

Documenting the busiest hours, seasonal variation, and the special events that distort staffing gives the pattern something concrete to fit. Mobile workforce scheduling tools help manage that variation once it is mapped.

That same mapping also shows where thin coverage hurts throughput most, and that finding drives every decision that follows.

Step 2: Select Shift Length

The choice between 8-hour, 10-hour, and 12-hour shifts affects workload sustainability and compliance exposure more than any other single decision. Both mental and physical fatigue increase with longer shifts, according to guidance jointly published by the American Academy of Sleep Medicine and the Sleep Research Society in 2021, which also notes that a 12-hour shift plus a commute can leave too little time between shifts for adequate sleep.

Job intensity, physical demand, concentration requirements, and compensation structure all feed this decision. Eight-hour shifts reduce fatigue and support work-life balance; 12-hour shifts offer more days off and fewer handovers but raise burnout risk in demanding roles.

Step 3: Pick Rotation Style and Team Count

Fixed patterns keep employees on the same shift indefinitely, while rotating patterns cycle crews through different hours. Team configuration follows from that choice and from the shift length selected in Step 2, with three-team, four-team, and five-team structures each suiting different coverage requirements.

Rotation direction belongs in this step too, because moving crews forward through the day costs less in fatigue than moving them backward.

Step 4: Run Cost and Compliance Numbers

Model total labor cost with structural overtime included, factor in absence coverage, review compensation strategies for the shift premiums the pattern will require, and check the draft against the labor rules that apply in each location.

Maximum consecutive working days, rest periods between shifts, and overtime thresholds all belong on that checklist, and documenting the answers now is far cheaper than reconstructing them later.

Step 5: Validate With Employees

Employees working a proposed pattern spot practical problems management misses, making this the step with the highest return and the one most often skipped. Collecting feedback before the schedule is finalized surfaces childcare conflicts, commute problems, and handover issues while they are still cheap to fix.

Surveys, focus groups, and shift-floor conversations all work as collection methods. Explaining the reasoning behind the chosen pattern matters as much as collecting the input, because a crew that understands why a rotation exists tends to work it more willingly. Structured employee feedback at this stage also gives a baseline to compare against after the rollout.

How to Choose the Right Shift Length

Choose 8-hour shifts for safety-critical or physically intense work, 12-hour shifts where the work is moderate and extended blocks of days off matter most to the workforce, and 10-hour shifts for compressed schedules without 12-hour fatigue.

Shift length sets fatigue exposure, handover frequency, and the overtime budget in one decision, which is why it comes before pattern selection, not after.

8-Hour Shifts Suit High-Risk Operations

Eight-hour shifts align with natural energy cycles and keep fatigue manageable across the shift, so alertness holds to the end. The trade-off is three handovers a day instead of two, which creates more opportunities for information to drop between crews, and fewer consecutive days off than longer patterns provide.

12-Hour Shifts Maximize Days Off and Raise Fatigue Risk

Twelve-hour patterns give employees more consecutive days off and cut scheduling complexity, which is why they dominate manufacturing and healthcare. The cost is real: performance declines in the final hours of a long shift, and the effect is sharpest in physically demanding roles.

10-Hour Shifts Split the Difference

Ten-hour shifts produce compressed workweeks and three-day weekends while avoiding the fatigue profile of a 12-hour shift. They work well in emergency services and moderate-intensity manufacturing where coverage needs to extend past a standard day without pushing people to their limits.

The scheduling arithmetic sharpens the comparison. Over four weeks, an 8-hour pattern typically requires 21 shifts per employee, while a 12-hour pattern requires only 14 for the same total hours, which is where the extra days off come from.

Physical demand and safety requirements should drive the final call. High-concentration and safety-critical work points to 8-hour shifts, operations where extended time off carries real value and intensity stays moderate can support 12-hour shifts, and 10-hour shifts sit between the two.

How to Choose Between Fixed, Rotating, and Hybrid Patterns

Use fixed patterns when schedule stability and deep role expertise matter most, rotating patterns when night and weekend burden has to be shared fairly across crews, and hybrid patterns when demand swings by day, season, or site.

The three approaches solve different problems, and the choice usually comes down to whether stability or fairness is the scarcer commodity in a given operation.

Fixed Patterns

Fixed patterns keep employees on the same shift permanently: always days, always evenings, or always nights. Sleep cycles stay consistent and personal lives stay plannable, which is the main argument for them.

The drawback is distributional, because someone has to hold the night shift indefinitely, and permanent night workers carry the long-term fatigue that comes with it. The standard example is the three-team fixed 8-hour pattern, with permanent assignments to days from 7 a.m. to 3 p.m., evenings from 3 p.m. to 11 p.m., or nights from 11 p.m. to 7 a.m.

Rotating Patterns

Rotating patterns move employees through different shifts over time, spreading the night burden and giving everyone varied experience. The cost is circadian: crews repeatedly adjust their sleep windows, and the body never fully settles. Common examples include the 4x12 rotation and the 2-2-3 schedule, called Panama when crews rotate between days and nights and Pitman when each crew stays fixed, along with the Swedish 2-2-2 pattern and its four-day break.

Hybrid Patterns

Hybrid patterns mix fixed and rotating elements or build specialized arrangements around a specific constraint. Weekend-only crews alongside regular rotating staff, or different shift lengths on different days, both fall into this category, and this flexibility lets staffing follow demand rather than the calendar.

Coverage stability, workforce preference, and health impact are the three inputs to this decision. Rotating shift workers, particularly those moving between day and night work, face increased risk of sleep disorders and chronic health problems, so the fairness argument for rotation has to be weighed against the health cost it carries.

Get started for free with Yourco

How to Calculate Staffing, Costs and Compliance

One continuously staffed position needs roughly five employees. Dividing 168 weekly coverage hours by a 40-hour workweek gives 4.2 full-time equivalents before accounting for any employee unavailability, and absence coverage takes it the rest of the way.

Getting this number wrong in either direction is expensive, so run the arithmetic below before the pattern is locked.

Start With the Basic Formula

The baseline calculation uses a fixed three-team 8-hour pattern:

168 coverage hours ÷ 40 = 4.2 FTE (Full-Time Equivalent) per position

Breaking that down:

  • 168: total hours in a week, or 24 hours across 7 days
  • 40: standard full-time hours per employee per week
  • 4.2: full-time equivalents needed before accounting for time off

That figure covers the post only if nobody is ever absent, which no real operation achieves, so it functions as a floor rather than a plan. Always round up.

The Complete Staffing Formula

Adding an absence factor turns the floor into a hiring number:

Employees needed = (total coverage hours per week ÷ average hours per employee per week) × absence factor

The absence factor accounts for vacation, sick leave, training days, and everything else that removes a scheduled person from the floor. Three multipliers cover most operations:

  • 1.1: low-absence environments with minimal time off
  • 1.2: typical operations with standard vacation and sick time
  • 1.3: high-absence environments or roles requiring extensive training

Applying the typical multiplier to the three-team example gives 4.2 × 1.2 = 5.04 employees per position, which rounds to five and explains the five-person planning figure.

Worked Example: One 24/7 Post on a Pitman Schedule

The assumptions are one position staffed at all times, meaning 168 coverage hours per week, 12-hour shifts on a Pitman rotation with four crews averaging 42 scheduled hours per week, and the U.S. federal standard under the Fair Labor Standards Act (FLSA) of overtime pay after 40 hours in a fixed workweek, with no averaging across weeks permitted, according to the U.S. Department of Labor.

  • Coverage requirement: 168 hours per week for one post, or 8,736 hours per year.
  • Baseline crews: 168 ÷ 42 = 4.0. Four Pitman crews cover the post exactly, with zero slack, and that baseline holds only if nobody is ever absent.
  • Relief-adjusted headcount: four crews is the paper requirement, not the hiring number. Applying the typical 1.2 absence factor to those four crew slots gives 4.8, and applying it to the 4.2 FTE baseline from the 40-hour calculation gives 5.04, so the planning figure is five people per continuously covered post. Scale it linearly, so a control room with three simultaneous posts needs roughly fifteen.
  • Where overtime enters: Pitman crews alternate 36-hour and 48-hour workweeks, three 12-hour shifts one week and four the next. Because the FLSA calculates each workweek on its own, 8 overtime hours accrue in every 48-hour week, which works out to roughly 208 hours of built-in overtime per crew member per year before a single call-out. Overtime also creeps in when absence coverage pushes someone into an extra shift, when the long week coincides with mandatory training, and in states with daily overtime thresholds regardless of weekly totals. DuPont distributes hours differently, swinging from 0 to 72 scheduled hours across its 28-day cycle, so its overtime arrives in concentrated bursts rather than a steady rhythm.

Legal Compliance Checkpoints

Six checks catch most of the problems that surface after a schedule goes live:

  • Maximum consecutive days worked: many jurisdictions limit continuous work periods
  • Required rest periods between shifts: verify recovery time between shift changes, particularly across rotation boundaries
  • Overtime thresholds and calculations: track when overtime begins, typically after 40 hours weekly under federal law, though several states including California, Alaska, Colorado, and Nevada also apply a daily threshold
  • Night work rules: some jurisdictions add requirements for overnight shifts
  • Documentation for extended shifts: keep records supporting longer shifts where they are used
  • Industry-specific rules: healthcare, transportation, and several other sectors carry their own hours limits

Working through the six before publication is considerably cheaper than reconstructing the reasoning during an audit.

Adjust for Jurisdiction

The worked example above uses only federal weekly overtime rules. Many employers in California, Alaska, Colorado, and Nevada also face daily overtime thresholds. In California, hours beyond 8 in a workday earn overtime and hours beyond 12 earn double time, so a 12-hour shift carries four daily overtime hours regardless of the weekly total.

With a prior written agreement, hospitals and residential care facilities may instead use the 8-and-80 system, paying overtime for hours past 8 in a day and 80 hours in a 14-day period. Collective bargaining agreements commonly set terms more generous than either.

This information is for general awareness only. For specific compliance guidance, consult with qualified legal professionals.

Avoid Expensive Mistakes

Understaffing produces burnout, safety incidents, and service failures. Overstaffing wastes payroll on hours the operation does not need. The formulas above defend against both, and you should re-run them against actual attendance and productivity data rather than treat them as a one-time calculation.

How to Protect Your Team From Shift Work Health Risks

Forward rotation and short night blocks reduce fatigue risk more than any other design choice, and employees also need practical sleep guidance. Work-schedule guidance from the National Institute for Occupational Safety and Health (NIOSH) states that forward rotations are easier to adjust to than backward rotations, because the body clock adjusts more easily by delaying sleep than by advancing it, and advises at least 11 hours between consecutive shifts.

Shift work carries real health risks and real workplace hazards, and both show up in productivity and incident numbers before they show up anywhere else.

Design Forward Rotations With Real Recovery Time

Rotations that move forward through the day, from morning to afternoon to night, work with employees’ sleep cycles rather than against them. Workers moving between day and night shifts face higher risk of sleep disorders and chronic health problems, which is why direction is not a cosmetic choice. The Swedish 2-2-2 pattern applies the principle directly, using four consecutive days off to let sleep patterns reset completely.

Keep Night Blocks Short

Capping night runs at two to four consecutive shifts is the standard countermeasure, because fatigue accumulates across a block rather than resetting overnight. Longer shifts compound the effect, and fatigue reported beyond 8 hours is why 12-hour night blocks warrant tighter caps than 8-hour ones.

Give Crews Practical Tools

Sleep hygiene training, nutrition guidance built for night workers, heat safety tips, and fatigue management education all address the alertness and cognitive effects that follow circadian disruption. The checklist below is the version most operations hand directly to employees.

  • Keep consistent sleep schedules, even on days off
  • Create a dark, quiet, and cool sleep environment
  • Time caffeine deliberately and avoid it in the six hours before sleep
  • Manage light exposure: bright during work, dark before sleep
  • Exercise regularly, but not close to bedtime
  • Eat lighter meals during night shifts

Handing that list out once achieves little; building it into shift briefings and supervisor conversations is what makes it stick.

How to Monitor and Optimize Your 24 Hour Coverage Shift Schedule After Launch

Monitor a new 24 hour coverage shift schedule on a 30-, 60-, and 90-day cycle: check operational coverage and quick fixes at 30 days, workforce metrics such as absenteeism and overtime at 60, and run a full pre-and-post comparison of productivity, safety, and cost at 90.

A structured review cycle captures what is working and corrects what isn't before it hardens into a permanent feature of the operation.

The 30-day review focuses on immediate operational impact, checking whether every shift is fully staffed without excessive overtime, whether handover quality holds between crews, and what employees are saying about the transition.

Quick wins at this stage usually involve break timing or clarifying handover procedures, both of which can be changed the same week.

At the 60-day mark, the analysis widens to performance indicators: absenteeism rates, overtime hours, and patterns in employee feedback, alongside supervisor observations about team dynamics and energy levels across shifts. Addressing communication issues during this window keeps small friction from becoming turnover.

The 90-day review is the full assessment, comparing pre-implementation and post-implementation data across productivity, quality, service delivery, employee satisfaction, and total labor cost. That comparison is the decision point for continuing, modifying, or replacing the pattern.

Four metric groups cover the ground:

  • Operational: productivity rates, quality scores, service levels
  • Workforce: absenteeism, tardiness, turnover, overtime hours
  • Safety: incident reports, near-misses, error rates
  • Wellbeing: satisfaction surveys, work-life balance feedback, health indicators

Collecting that input across every shift is the part that usually breaks, because daytime surveys reliably reach only day-shift employees. SMS-based platforms like Yourco run polls and surveys over text at each review stage, which pulls responses from night and weekend crews on the same terms as everyone else.

Track worker sentiment with pulse surveys and polls.

Great Day Improvements, a home improvement company running 338 locations, uses the same message-level visibility to track the concerns employees raise most often across sites, including scheduling concerns and call-off trends, according to its published results with the platform.

Documenting what worked and what didn't, then returning to the original staffing calculations to check projections against reality, closes the loop and gives the next revision a baseline.

How to Customize 24 Hour Coverage Shift Schedules When Standard Patterns Don’t Fit

Customize when no standard pattern matches the demand curve. Start from the closest proven pattern and change only the elements the demand curve requires, because every deviation adds administrative cost.

Peak hours concentrated in a narrow window, a workforce with strong scheduling preferences, or a site with weekend demand unlike its weekday demand all push operations toward a hybrid. Three variations cover most of those cases.

Day-Shift Heavy Operations

Where activity concentrates in daylight hours, a 5 a.m. to 3:30 p.m. four-day schedule extends prime-time coverage while giving employees a compressed workweek and three-day weekends. Distribution centers and retail operations benefit most, because they get extended coverage without the cost and complexity of full 24/7 staffing.

Contractor-Led Weekend Crews

A core team works three standard 8-hour shifts Monday through Friday while contract workers handle weekend coverage. Permanent employees keep predictable weekday schedules, weekend staffing scales with demand, and core-team retention improves. The challenge is transferring knowledge between permanent and contract staff, which needs a deliberate handover process rather than an assumption.

Alternative Rotation Blocks

Patterns such as 6-on-3-off and 5-on-3-off give longer recovery periods between work blocks, which appeals to employees who prefer concentrated work followed by extended time off. The longer blocks can reduce burnout, though they also lengthen the stretch during which fatigue accumulates.

Custom approaches let team size, shift length, and rotation cadence move independently, which improves both coverage fit and employee satisfaction at the cost of administrative complexity. Running full cost modeling before committing is what separates a hybrid that pays for itself from one that only adds overhead. Seasonal operations, growing businesses, and sites with distinct weekend and weekday demand are where the trade usually comes out positive.

Troubleshooting Common Pain Points

Troubleshoot a 24 hour coverage shift schedule by matching each symptom to its structural cause: unfilled shifts and excess overtime usually trace back to baseline staffing levels, while burnout, swap chaos, and compliance slips trace back to rotation design and policy.

Scheduling challenges are unavoidable in continuous operations. The six below account for most of them.

Coverage Gaps

Understaffing during peak periods, predictable absence patterns nobody accounted for, and weak handover processes are the usual root causes of shift coverage problems. Overlap shifts during transitions, a structured on-call rotation, and cross-training across roles and shifts all address them, and staffing calculations need revisiting whenever shift length changes, because a number that worked for 8-hour shifts rarely survives the move to 12-hour patterns.

Reaching people is the other half of the problem: 56% of HR leaders say they have missed vital deadlines because they could not reach a frontline employee in time, according to a Yourco-commissioned survey of 150 HR leaders.

Excess Overtime

Unrealistic scheduling assumptions and inadequate baseline staffing drive most overtime costs. Analyzing overtime patterns to find the recurring problem areas, adjusting base staffing accordingly, and setting alerts when overtime approaches a threshold all help. When a coverage gap opens, SMS-based platforms like Yourco reach available staff across every crew at once, finding voluntary coverage before mandatory overtime becomes the only option.

Burnout Complaints

Limiting consecutive long shifts, protecting rest periods between blocks, and rotating undesirable shifts fairly are the structural answers. Regular pulse surveys over text catch early signals across all shifts, not just the crews a manager sees in person.

Swap Chaos

Uncontrolled shift swapping creates coverage risk that nobody notices until the shift starts. Clear policies defining who may swap with whom, an advance-notice requirement, and mandatory managerial approval resolve most of it, and handling swap requests over a channel that timestamps and logs every message keeps a record of what was actually approved. Handling scheduling conflicts through one process stops two managers approving the same swap twice.

Last-Minute Call-Outs

Contingency planning covers the predictable part: a standing list of employees willing to pick up extra shifts, incentives for reliable attendance, and defined protocols for different absence types.

The intake itself is where supervisor time disappears, and the Yourco AI Call-Off Agent handles that side over two-way SMS, collecting the dates and reason from the employee, asking follow-up questions until the record is complete, confirming the request back to the employee, notifying the supervisor, and logging a timestamped call-off record for reporting. The agent now handles partial-day absences alongside full-shift call-offs:

  • Manage every type of call-off: Track full-shift call-offs, late-ins, and early-outs through one standardized process.
  • Track exactly how much time is missed: Automatically capture the total hours an employee misses.
  • Automate leave categorization: Automatically categorize call-offs by customized leave types such as PTO, UTO, and FMLA for more consistent reporting.

In the same survey of 150 HR leaders, 85% said improved communication would reduce absenteeism. A faster, cleaner intake starts there, because the supervisor hears about the gap while there is still time to fill it.

Legal Non-Compliance

Compliance problems in shift work usually trace to inadequate rest periods, excessive consecutive hours, or overtime calculated on the wrong basis. Weekly schedule audits against the applicable rules, documentation of scheduling decisions and exceptions, and compliance checks built into the scheduling process itself catch most of them.

About one in four U.S. workers face unpredictable schedules, meaning they do not know their hours at least two weeks out, and workers with low-quality schedules are far more likely to say work conflicts with personal life, 57% versus 39%, according to the 2025 American Job Quality Study from Gallup, Jobs for the Future, and the W.E. Upjohn Institute for Employment Research. Consistent patterns are the cheapest available countermeasure.

Cross-Industry Adaptability

The core principles carry across industries while the implementation varies. Healthcare facilities schedule around patient acuity, manufacturing schedules around production cycles, and security services schedule around threat levels and special events. Adapting the approach means understanding the industry’s demand patterns, regulatory requirements, and skill-mix needs while keeping the fundamentals of fairness, adequate rest, and clear communication constant. Where turnover stays high despite a well-designed pattern, exit survey questions usually reveal whether the schedule or something else is the cause.

Keep Every Crew Connected With Yourco

A 24 hour coverage shift schedule only delivers when every crew hears about changes in time to act on them, which makes the communication channel part of the schedule design rather than a separate project. Yourco is an SMS-based employee communication platform that puts the company side of every shift conversation on one channel reaching all four crews at once, without asking anyone to download an app or remember a password.

Three capabilities carry that across a continuous operation:

  • SMS reaches any phone, including basic flip phones, with no app download, Wi-Fi, or data plan required
  • Two-way messaging lets supervisors confirm coverage and employees reply from the floor
  • AI-powered translation across 135+ languages and dialects delivers each message in the employee’s preferred language

Human Resources Information System (HRIS) and payroll data sync through Yourco’s 240+ integrations, so crew assignments and contact records stay current as people move between rotations and sites.

For multi-site operations, Enterprise Bridge gives corporate leadership a one-way channel to broadcast policy, safety, and schedule-wide updates across every location at once, while local managers keep direct two-way conversations with their own crews.

Frontline Intelligence gives HR and operations teams centralized visibility into coverage communication across all locations. Leadership can see which sites confirm schedule changes fastest, surface the operational themes crews raise most often, including scheduling concerns and call-off activity, and compare those patterns site by site before a coverage problem becomes a turnover problem, with direct answers to:

  • Which locations had the most call-offs this month?
  • Are certain shifts seeing more attendance issues?
  • What scheduling concerns are employees raising most often?

“We use Yourco for our absence management and for sending out notices, reminders, and event announcements. It keeps everyone who needs to know informed when people are absent.”

— Kyle Stover, HR Assistant, J-Lenco Inc.

After 90 days on Yourco, companies see two-way employee engagement reach 86%.

Try Yourco free today or schedule a demo to see the difference the right workplace communication solution can make.

Yourco banner with hospitality, manufacturing, and construction workers

Frequently Asked Questions About 24 Hour Coverage Shift Schedules

What Are the Shifts for 24-Hour Coverage?

Three common structures cover 24 hours. Three 8-hour shifts run 7 a.m. to 3 p.m., 3 p.m. to 11 p.m., and 11 p.m. to 7 a.m. Two 12-hour shifts run 7 a.m. to 7 p.m. and 7 p.m. to 7 a.m. The 4-on/4-off 12-hour pattern gives four consecutive shifts followed by four days off.

How Do I Build a 24-Hour Shift Schedule?

Start by mapping operational demand and minimum staffing for each role and hour. Select a shift length that matches job intensity, choose between fixed and rotating patterns, model labor cost and compliance exposure including structural overtime, then validate the draft with the employees who will work it before publishing.

What Is the 24/7 Shift Pattern Formula?

Divide 168 weekly coverage hours by a 40-hour workweek to get 4.2 full-time equivalents per continuously staffed position. Multiply that by an absence factor, typically 1.2 for standard vacation and sick time, to get 5.04 and explain why one round-the-clock post generally needs five people.

What Is the Difference Between the Pitman and Panama Schedule?

Pitman and Panama run the same 2-2-3 work sequence with 12-hour shifts and four crews. The difference is day and night assignment: Pitman crews stay permanently on days or nights across a 14-day cycle, while Panama crews rotate between days and nights over 28 days. Policing favors Pitman; manufacturing favors Panama.

Do 12-Hour Rotating Shifts Create Overtime?

Most 12-hour continuous patterns build overtime into the schedule. A crew on a 2-2-3 rotation alternates 36-hour and 48-hour workweeks, and because federal law calculates overtime separately for each workweek, every 48-hour week carries eight overtime hours. Budget for that before adding call-out or absence coverage.

What Is the Healthiest Rotating Shift Schedule?

A forward-rotating schedule that moves crews from day to evening to night, caps night work at two to four consecutive shifts, and protects recovery time between blocks. Forward rotation works with the body clock, which adjusts more easily by delaying sleep than by advancing it, so occupational health researchers recommend it over backward rotation.

What Is the Best 24-Hour Coverage Shift Schedule for Manufacturing?

Four-crew 12-hour patterns such as the 2-2-3 Panama and DuPont are the most common manufacturing choices, because they keep production lines running on a predictable rotation. The 2-2-3 caps consecutive shifts at three, while DuPont trades one demanding week for seven straight days off. SMS-based platforms like Yourco help plant managers confirm coverage across every crew.

Latest blogs

Construction worker using a tablet in an industrial facility.
Shift Report Format Guide: Types, Key Elements and Best Practices
Build a shift report format your frontline crews will actually complete: the four report types, seven key components, a template structure and rollout steps.
11 Sep 2026
Read story
Man reclining on a sofa in a living room.
How to Talk to an Employee About Excessive Absenteeism
Excessive absenteeism drains productivity and morale. Get a step-by-step conversation framework, legal guardrails, and a documented improvement plan template.
11 Sep 2026
Read story
Two workers in hi-vis vests and hard hats.
Rotating Shift Schedules Explained: Pros, Cons, and Best Practices
What is a rotating shift? Compare DuPont, Pitman, 2-2-3 and Continental patterns, plus the pros, cons and rules managers need before choosing one.
10 Sep 2026
Read story
